In this Section, we enlarge the scope of our discussion to include other
major activities associated with quality assurance (QA) for software systems,
primarily in the areas of setting quality goals, planning for QA, monitoring
QA activities, and providing feedback for project management and quality
improvement.
1. QUALITY ENGINEERING: ACTIVITIES AND PROCESS
As stated in Section 2, different customers and users have different quality
expectations under different market environments. Therefore, we need to
move beyond just performing QA activities toward quality engineering by
managing these quality expectations as an engineering problem: Our goal
is to meet or exceed these quality expectations through the selection and
execution of appropriate QA activities while minimizing the cost and other
project risks under the project constraints.
In order to ensure that these quality goals are met through the selected
QA activities, various measurements need to be taken parallel to the QA
activities themselves. Postmortem data often need to be collected as well.
Both in-process and post-mortem data need to be analyzed using various models
to provide an objective quality assessment. Such quality assessments not
only help us determine if the preset quality goals have been achieved, but
also provide us with information to improve the overall product quality.
To summarize, there are three major groups of activities in the quality
engineering process, as depicted in Figure 1. They are labeled in roughly
chronological order as pre-QA activities, in-QA activities, and post-QA
activities:

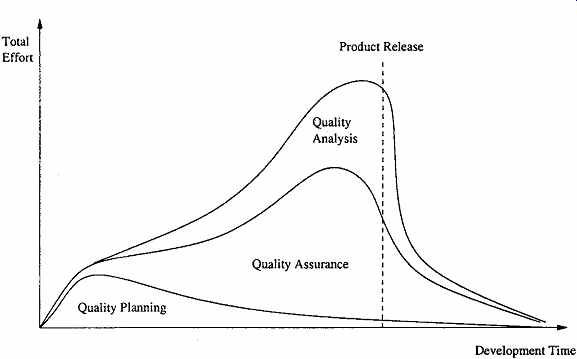

Figure 1 Quality engineering process
1. Pre-QA activities: Quality planning. These are the activities that should
be carried out before carrying out the regular QA activities. There are
two major types of pre-QA activities in quality planning, including: (a)
Set specific quality goals.
(b) Form an overall QA strategy, which includes two sub-activities:
i. Select appropriate QA activities to perform.
ii. Choose appropriate quality measurements and models to provide feedback,
quality assessment and improvement.
A detailed description of these pre-QA activities is presented in Section
2.
2. In-QA activities: Executing planned QA activities and handling discovered
defects.
In addition to performing selected QA activities, an important part of
this normal execution is to deal with the discovered problems. These activities
were described in the previous two Sections.
3. Post-QA activities: Quality measurement, assessment and improvement
These are the activities that are carried out after normal QA activities
have started but not as part of these normal activities. The primary purpose
of these activities is to provide quality assessment and feedback so that
various management decisions can be made and possible quality improvement
initiatives can be carried out. These activities are described in Section
3.
Notice here that "post-QA" does not mean after the finish of
QA activities. In fact, many of the measurement and analysis activities
are carried out parallel to QA activities after they are started. In addition,
pre-QA activities may overlap with the normal QA activities as well.
Pre-QA quality planning activities play a leading role in this quality
engineering process, although the execution of selected QA activities usually
consumes the most resources.
Quality goals need to be set so that we can manage the QA activities and
stop them when the quality goals are met. QA strategies need to be selected,
before we can carry out specific QA activities, collect data, perform analysis,
and provide feedback.
There are two kinds of feedback in this quality engineering process, both
the short term direct feedback to the QA activities and the long-term feedback
to the overall quality engineering process. The short term feedback to QA
activities typically provides information for progress tracking, activity
scheduling, and identification of areas that need special attentions. For
example, various models and tools were used to provide test effort tracking,
reliability monitoring, and identification of low-reliability areas for
various software products developed in the IBM Software Solutions Toronto
Lab to manage their testing process.
The long-term feedback to the overall quality engineering process comes
in two forms:
--Feedback to quality planning so that necessary adjustment can be made
to quality goals and QA strategies. For example, if the current quality
goals are unachievable, alternative goals need to be negotiated. If the
selected QA strategy is inappropriate, a new or modified strategy needs
to be selected. Similarly, such adjustments may also be applied to future
projects instead of the current project.
--Feedback to the quality assessment and improvement activities. For example,
the modeling results may be highly unstable, which may well be an indication
of the model inappropriateness. In this case, new or modified models need
to be used, probably on screened or pre-processed data.
Quality engineering and QIP
In the TAME project and related work (Basili and Rombach, 1988; Oivo and
Basili, 1992; Basili, 1995; van Solingen and Berghout, 1999), quality improvement
was achieved through measurement, analysis, feedback, and organizational
support. The overall framework is called QIP, or quality improvement paradigm.
QIP includes three interconnected steps: understanding, assessing, and packaging,
which form a feedback and improvement loop, as briefly described below:
1. The first step is to understand the baseline so that improvement opportunities
can be identified and clear, measurable goals can be set. All future process
changes are measured against this baseline.
2. The second step is to introduce process changes through experiments,
pilot projects, assess their impact, and fine tune these process changes.
3. The last step is to package baseline data, experiment results, local
experience, and updated process as the way to infuse the findings of the
improvement program into the development organization.
QIP and related work on measurement selection and organizational support
are described further in connection to defect prevention in Section 13 and
in connection to quality assessment and improvement in Part IV. Our approach
to quality engineering can be considered as an adaptation of QIP to assure
and measure quality, and to manage quality expectations of target customers.
Some specific correspondences are noted below:
--Our pre-QA activities roughly correspond to the understand step in QIP.
The execution of our selected QA strategies correspond to the "changes" introduced
in the assess step in QIP. However, we are focusing on the execution of
normal QA activities and the related measurement activities selected previously
in our planning step, instead of specific changes.
Our analysis and feedback (or post-QA) activities overlap with both the
assess and package steps in QIP, with the analysis part roughly corresponding
to the QIP-assess step and the longer term feedback roughly corresponding
to the QIP-package step.
2. QUALITY PLANNING: GOAL SETTING AND STRATEGY FORMATION
As mentioned above, pre-QA quality planning includes setting quality goals
and forming a QA strategy. The general steps include:
1. Setting quality goals by matching customer's quality expectations with
what can be economically achieved by the software development organizations
in the following sub-steps: (a) Identify quality views and attributes meaningful
to target customers and users.
(b) Select direct quality measures that can be used to measure the selected
quality attributes from customer's perspective.
(c) Quantify these quality measures to set quality goals while considering
the market environment and the cost of achieving different quality goals.
2. In forming a QA strategy, we need to plan for its two basic elements:
(a) Map the above quality views, attributes, and quantitative goals to
select a specific set of QA alternatives.
(b) Map the above external direct quality measures into internal indirect
ones via selected quality models. This step selects indirect quality measures
as well as usable models for quality assessment and analysis.
We next examine these steps and associated pre-QA activities in detail.
Setting quality goals
One important fact in managing customer's quality expectations is that
different quality attributes may have different levels of importance to
different customers and users. Relevant quality views and attributes need
to be identified first. For example, reliability is typically the primary
concern for various business and commercial software systems because of
people's reliance on such systems and the substantial financial loss if
they are malfunctioning.
Similarly, if a software is used in various real-time control situations,
such as air traffic control software and embedded software in automobile,
medical devices, etc., accidents due to failures may be catastrophic. Therefore,
safety is the major concern. On the other hand, for mass market software
packages, such as various auxiliary utilities for personal computers, usability,
instead of reliability or safety, is the primary concern.
Even in the narrower interpretation of quality we adopted in this guide
to be the correctness centered quality attributes associated with errors,
faults, failures, and accidents, there are different types of problems and
defects that may mean different things to different customers.
For example, for a software product that is intended for diverse operational
environments, inter-operability problems may be a major concern to its customers
and users; while the same problems may not be a major concern for software
products with a standard operational environment. Therefore, specific quality
expectations by the customers require us to identify relevant quality views
and attributes prior to setting appropriate quality goals.
This needs to be done in close consultation with the customers and users,
or those who represents their interests, such as requirement analysts, marketing
personnel, etc.
Once we obtained qualitative knowledge about customers' quality expectations,
we need to quantify these quality expectations to set appropriate quality
goals in two steps:
1. We need to select or define the quality measurements and models commonly
accepted by the customers and in the software engineering community. For
example, as pointed out in Section 2, reliability and safety are examples
of correctness-centered quality measures that are meaningful to customers
and users, which can be related to various internal measures of faults commonly
used within software development organizations.
2. We need to find out the expected values or ranges of the corresponding
quality measurements. For example, different market segments might have
different reliability expectations. Such quality expectations are also influenced
by the general market conditions and competitive pressure.
Software vendors not only compete on quality alone, but also on cost, schedule,
innovation, flexibility, overall user experience, and other features and
properties as well. Zero defect is not an achievable goal under most circumstances,
and should not be the goal.
Instead, zero defection and positive flow of new customers and users based
on quality expectation management should be a goal (Reichheld Jr. and Sasser,
1990). In a sense, this activity determines to a large extent the product
positioning vs. competitors in the marketplace and potential customers and
users.
Another practical concern with the proper setting of quality goals is the
cost associated with different levels of quality. This cost can be divided
into two major components, the failure cost and the development cost. The
customers typically care more about the total failure cost, Cf, which can
be estimated by the average single failure cost, cf, and failure probability,
pf, over a pre-defined duration of operation as:
Cf =Cf x pf.
As we will see later in Section 22, this failure probability can be expressed
in terms of reliability, R, as pf = 1 R, where R is defined to be the probability
of failure-free operations for a specific period of given set of input.
To minimize Cf, one can either try to minimize cf or pf. However, cf is
typically determined by the nature of software applications and the overall
environment the software is used in. Consequently, not much can be done
about cf reduction without incurring substantial amount of other cost. One
exception to this is in the safety critical systems, where much additional
cost was incurred to establish barriers and containment in order to reduce
failure impact, as described in Section 16. On the other hand, minimizing
pf, or improving reliability, typically requires additional development
cost, in the form of additional testing time, use of additional QA techniques,
etc.
Therefore, an engineering decision need to be made to match the quantified
customer's quality expectations above with their willingness to pay for
the quality. Such quantitative cost-of-quality analyses should help us reach
a set of quality goals.
Forming a QA strategy
Once specific quality goals were set, we can select appropriate QA alternatives
as part of a QA strategy to achieve these goals. Several important factors
need to be considered: The influence of quality-perspectives and attributes:
For different kinds of customers, users, and market segments, different
QA alternatives might be appropriate, because they focus on the assurance
of quality attributes based on this specific perspective. For example, various
usability testing techniques may be useful for ensuring the usability of
a software product, but may not be effective for ensuring its functional
correctness.
The influence of different quality Levels: Quantitative quality levels
as specified in the quality goals may also affect the choice of appropriate
QA techniques. For example, systems with various software fault tolerance
features may incur substantially more additional cost than the ones without
them. Therefore, they may be usable for highly dependable systems or safety
critical systems, where large business operations and people's lives may
depend on the correct operations of software systems, but may not be suitable
for less critical software systems that only provide non-essential information
to the users.
Notice that in dealing with both of the above factors, we assume that there
is a certain relationship between these factors and specific QA alternatives.
Therefore, specific QA alternatives need to be selected to fulfill specific
quality goals based on the quality perspectives and attributes of concern
to the customers and users.
Implicitly assumed in this selection process is a good understanding of
the advantages and disadvantages of different QA alternatives under different
application environments.
These comparative advantages and disadvantages are the other factors that
also need to be considered in selecting different QA after natives and related
techniques and activities.
These factors include cost, applicability to different environments, effectiveness
in dealing with different kinds of problems, etc. discussed in Section 17.
In order to achieve the quality goals, we also need to know where we are
and how far away we are from the preset quality goals. To gain this knowledge,
objective assessment using some quality models on collected data from the
QA activities is necessary. As we will discuss in more detail in Section
18, there are direct quality measures and indirect quality measures. The
direct quality measures need to be defined as part of the activities to
set quality goals, when such goals are quantified.
Under many situations, direct quality measures cannot be obtained until
it is already too late. For example, for safety critical systems, post-accident
measurements provide a direct measure of safety. But due to the enormous
damage associated with such accidents, we are trying to do everything to
avoid such accidents. To control and monitor these safety assurance activities,
various indirect measurements and indicators can be used. For all software
systems there is also an increasing cost of fixing problems late instead
of doing so early in general, because a hidden problem may lead to other
related problems, and the longer it stays undiscovered in the system, the
further removed it is from its root causes, thus making the discovery of
it even more difficult. Therefore, there is a strong incentive for early
indicators of quality that usually measure quality indirectly.
Indirect quality measures are those which can be used in various quality
models to assess and predict quality, through their established relations
to direct quality measures based on historical data or data from other sources.
Therefore, we also need to choose appropriate measurements, both direct
and indirect quality measurement, and models to provide quality assessment
and feedback. The actual measurement and analysis activities and related
usage of analysis results are discussed in Section 18.
3. QUALITY ASSESSMENT AND IMPROVEMENT
Various parallel and post-QA activities are carried out to close the quality
engineering loop.
The primary purpose of these activities is to provide quality assessment
and feedback so that various management decisions, such as product release,
can be made and possible quality and process improvement initiatives can
be carried out. The major activities in this category include:
--Measurement: Besides defect measurements collected during defect handling,
which is typically carried out as part of the normal QA activities, various
other measurements are typically needed for us to track the QA activities
as well as for project management and various other purposes. These measurements
provide the data input to subsequent analysis and modeling activities that
provide feedback and useful information to manage software project and quality.
--Analysis and modeling: These activities analyze measurement data from
software projects and fit them to analytical models that provide quantitative
assessment of selected quality characteristics or sub-characteristics. Such
models can help us obtain an objective assessment of the current product
quality, accurate prediction of the future quality, and some models can
also help us identify problematic areas.
--Providing feedback and identifying improvement potentials: Results from
the above analysis and modeling activities can provide feedback to the quality
engineering process to help us make project scheduling, resource allocation,
and other management decisions. When problematic areas are identified by
related models, appropriate remedial actions can be applied for quality
and process improvement.
--Follow-up activities: Besides the immediate use of analysis and modeling
results described above, various follow-up activities can be carried out
to affect the long-term quality and organizational performance. For example,
if major changes are suggested for the quality engineering process or the
software development process, they typically need to wait until the current
process is finished to avoid unnecessary disturbance and risk to the current
project.
The details about these activities are described in Part IV.
4. QUALITY ENGINEERING IN SOFTWARE PROCESSES
The quality engineering process forms an integral part of the overall software
engineering process, where other concerns, such as cost and schedule, are
also considered and managed.
As described in Section 4, individual QA activities can be carried out
and integrated into the software process. When we broaden our scope to quality
engineering, it also covers pre-QA quality planning as well as the post-QA
measurement and analysis activities carried out parallel to and after QA
activities to provide feedback and other useful information.
All these activities and the quality engineering process can be integrated
into the overall software process as well, as described below.
Activity distribution and integration
Pre-QA quality planning can be an integral part of any project planning.
For example, in the waterfall process, this is typically carried out in
the phase for market analysis, requirement gathering, and product specification.
Such activities also provide us with valuable information about quality
expectations by target customers and users in the specific market segment
a software vendor is prepared to compete in. Quality goals can be planned
and set accordingly. Project planning typically includes decisions on languages,
tools, and technologies to be used for the intended software product. It
should be expanded to include 1) choices of specific QA strategies and 2)
measurement and models to be used for monitoring the project progress and
for providing feedback.
In alternative software processes other than waterfall, such as in incremental,
iterative, spiral, and extreme programming processes, pre-QA activities
play an even more active role, because they are not only carried out at
the beginning of the whole project, but also at the beginning of each subpart
or iteration due to the nature that each subpart includes more or less all
the elements in the waterfall phases. Therefore, we need to set specific
quality goals for each subpart, and choose appropriate QA activities, techniques,
measurement, and models for each subpart. The overall quality goal may evolve
from these sub-goals in an iterative fashion.
For normal project monitoring and management under any process, appropriate
measurement activities need to be carried out to collect or extract data
from the software process and related artifacts; analyses need to be performed
on these data; and management decision can be made accordingly. On the one
hand, the measurement activity cannot be carried out without the involvement
of the software development team, either as part of the normal defect handling
and project tracking activities, or as added activity to provide specific
input to related analysis and modeling. Therefore, the measurement activities
have to be handled
"on-line" during the software development process, with some
additional activities in information or measurement extraction carried out
after the data collection and recording are completed.
On the other hand, much of the analysis and modeling activities could be
done "off-line", to minimize the possible disruption or disturbance
to the normal software development process. However, timely feedback based
on the results from such analyses and models is needed to make adjustments
to the QA and to the development activities. Consequently, even such "off-line" activities
need to be carried out in a timely fashion, but may be at a lower frequency.
For example, in the implementation of testing tracking, measurement, reliability
analysis, and feedback for IBM's software products, dedicated quality analyst
performed such analyses and modeling and provided weekly feedback to the
testing team, while the data measurement and recording were carried out
on a daily basis.
The specific analysis, feedback, and follow-up activities in the software
quality engineering process fit well into the normal software management
activities. Therefore, they can be considered as an integral part of software
project management. Of course, the focus of these quality engineering activities
is on the quality management, as compared to the overall project management
that also includes managing project features, cost, schedule, and so on.

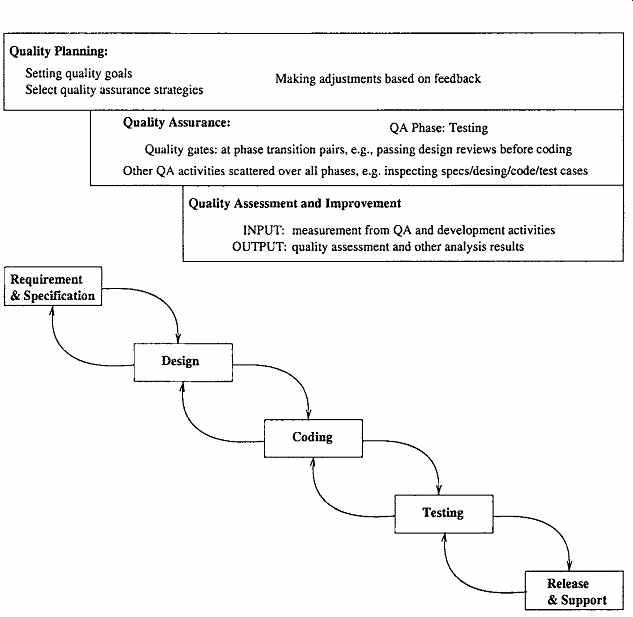

The integration of the quality engineering process into the waterfall software
development process can be illustrated by Figure 2. The horizontal activities
roughly illustrate the timeline correspondence to software development activities.
For example, quality planning starts right at the start of the requirement
analysis phase, followed by the execution of the selected QA activities,
and finally followed by the measurement and analysis activities.
All these activities typically last over the whole development process,
with different sub-activities carried out in different phases. This is particularly
true for the QA activities, with testing in the test phase, various reviews
or inspections at the transition from one phase to its successor phase,
and other QA activities scattered over other phases.
Minor modifications are needed to integrate quality engineering activities
into other development processes. However, the distribution of these activities
and related effort is by no means uniform over the activities or over time,
which is examined next.
-------------

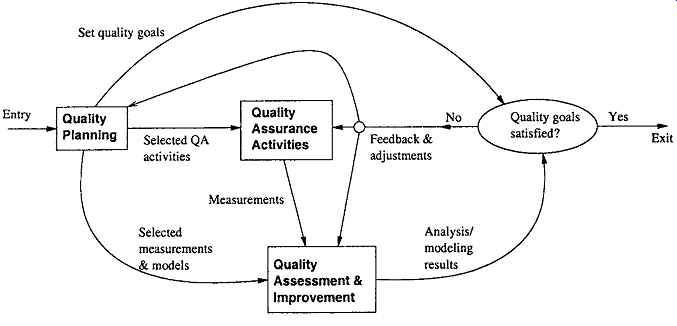

Figure 2 Quality engineering in the waterfall process
Quality Planning: Setting quality goals Select quality assurance strategies
Making adjustments based on feedback Quality Assurance: QA Phase: Testing
Quality gates: at phase transition pairs, e.g.. passing design reviews before
coding Other QA activities scattered over all phases, e.g. inspecting specs/design/code/test
cases INPUT measurement from QA and development activities
OUTPUT quality assessment and other analysis results
-------------
Effort profile
Among the three major types of activities in the quality engineering process,
the execution of specific QA activities is central to dealing with defects
and assuring quality for the software products. Therefore, they should and
normally do consume the most resources in terms of human effort as well
as utilization of computing and other related resources.
However, the effort distribution among the three is not constant over time
because of the process characteristics described above and the shifting
focus over time. Some key factors that affect and characterize the effort
profile, or the effort distribution over time, include:
--Quality planning drives and should precede the other two groups of activities.
Therefore, at the beginning part of product development, quality planning
should be the dominant part of quality engineering activities. Thereafter,
occasional adjustments
to the quality goals and selected quality strategies might be applied,
but only a small share of effort is needed.
The collective effort of selected QA activities generally demonstrates
the following pattern:
--There is a gradual build-up process for individual QA activities, and
for them collectively.
--The collective effort normally peaks off a little bit before product
release, when development activities wind down and testing activities are
the dominant activities.
--Around product release and thereafter, the effort tapers off, typically
with a sudden drop at product release.
Of course, the specific mix of selected QA activities as well as the specific
development process used would affect the shape of this effort profile as
well. But the general pattern is expected to hold.
Measurement and quality assessment activities start after selected QA activities
are well under way. Typically, at the early part of the development process,
small amounts of such activities are carried out to monitor quality progress.
But they are not expected to be used to make major management decisions
such as product release. These activities peak off right before or at the
product release, and lower gradually after that. In the overall shape and
pattern, the effort profile for these activities follows that for the collective
QA activities above, but with a time delay and a heavier load at the tail-end.
One common adjustment to the above pattern is the time period after product
release.
Immediately after product release or after a time delay for market penetration,
the initial wave of operational use by customers is typically accompanied
by many user-reported problems, which include both legitimate failures and
user errors. Consequently, there is typically an upswing of overall QA effort.
New data and models are also called for, resulting in an upswing of measurement
and analysis activities as well. The main reason for this upswing is the
difference between the environment where the product is tested under and
the actual operational environment the product is subjected to. The use
of usage-based testing described in Sections 8 and 10 would help make this
bump smoother.
This general profile can be graphically illustrated in Figure 3. The overall
quality engineering effort over time is divided into three parts:
The bottom part represents the share of total effort by quality planning
activities; The middle part represents the share of total effort for the
execution of selected QA activities;
The upper part represents the share of total effort for the measurement
and quality assessment activities.
Notice that this figure is for illustration purposes only. The exact profile
based on real data would not be as smooth and would naturally show large
amount of variability, with many small peaks and valleys. But the general
shape and pattern should preserve.
Figure 3 Quality engineering effort profile: The share of different activities
as part of the total effort.
In addition, the general shape and pattern of the profile such as in Figure
3 should preserve regardless of the specific development process used.
Waterfall process would see more dominance of quality planning in the
beginning, and dominance of testing near product release, and measurement
and quality assessment activities peak right before product release.
Other development processes, such as incremental, iterative, spiral, and
extreme programming processes, would be associated with curves that vary
less between the peaks and valleys. QA is spread out more evenly in these
processes than in the waterfall process, although it is still expected to
peak a little bit before product release. Similarly, measurement and analysis
activities are also spread out more evenly to monitor and assess each part
or increment, with the cumulative modeling results used in product release
decisions. There are also more adjustments and small-scale planning activities
involved in quality planning, which also makes the corresponding profiles
less variable as well.
5. CONCLUSION
To manage the quality assurance (QA) activities and to provide realistic
opportunities of quantifiable quality improvement, we need to go beyond
QA to perform the following: Quality planning before specific QA activities
are carried out, in the so-called pre-QA activities in software quality
engineering. We need to set the overall quality goal by managing customer's
quality expectations under the project cost and budgetary constraints. We
also need to select specific QA alternatives and techniques to implement
as well as measurement and models to provide project monitoring and qualitative
feedback.
Quality quantification and improvement through measurement, analysis, feedback,
and follow-up activities. These activities need to be carried out after
the start of specific QA activities, in the so-called post-QA activities
in software quality engineering.
The analyses would provide us with quantitative assessment of product quality,
and identification of improvement opportunities. The follow-up actions would
implement these quality and process improvement initiatives and help us
achieve quantifiable quality improvement.
The integration of these activities with the QA activities forms our software
quality engineering process depicted in Figure 1, which can also be integrated
into the overall software development and maintenance process. Following
this general framework and with a detailed description of pre-QA quality
planning in this Section, we can start our examination of the specific QA
techniques and post-QA activities in the rest of this guide.
QUIZ
1. What is the difference between quality assurance and quality engineering?
2. Why is quantification of quality goals important?
3. What can you do if certain quality goals are hard to quantify? Can you
give some concrete examples of such situations and practical suggestions?
4. There are some studies on the cost-of-quality in literature, but the
results are generally hard to apply to specific projects. Do you have some
suggestions on how to assess the cost-of-quality for your own project? Would
it be convincing enough to be relied upon in negotiating quality goals with
your customers?
5. As mentioned in this Section, the quality engineering effort profile
would be somewhat different from that in Figure 3 if processes other than
waterfall are used. Can you assess, qualitatively or quantitatively, the
differences when other development processes are used?
6. Based on some project data you can access, build your own quality engineering
effort profile and compare it to that in Figure 3. Pay special attention
to development process used and the division of planning, QA, and analysis/follow-up
activities.
PREV. | NEXT
Also see:
top of page | Article
Index | Home |
