<<PREV.
3. EFFORT ESTIMATION
One of the crucial aspects of project planning and management is understanding
how much the project is likely to cost. Cost overruns can cause customers
to cancel projects, and cost underestimates can force a project team
to invest much of its time without financial compensation. As described
in SIDEBAR 3, there are many reasons for inaccurate estimates. A good
cost estimate early in the project's life helps the project manager to
know how many developers will be required and to arrange for the appropriate
staff to be available when they are needed.
The project budget pays for several types of costs: facilities, staff,
methods, and tools. The facilities costs include hardware, space, furniture,
telephones, modems, heating and air conditioning, cables, disks, paper,
pens, photocopiers, and all other items that provide the physical environment
in which the developers will work. For some projects, this environment
may already exist, so the costs are well -understood and easy to estimate.
But for other projects, the environment may have to be created. For example,
a new project may require a security vault, a raised floor, temperature
or humidity controls or special furniture. Here, the costs can be estimated,
but they may vary from initial estimates as the environment is built
or changed. For instance, installing cabling in a building may seem straightforward
until the builders discover that the building is of special historical
significance, so that the cables must be routed around the walls instead
of through them.
===========
SIDEBAR 3
CAUSES OF INACCURATE ESTIMATES
Lederer and Prasad (1992) investigated the cost -estimation practices
of 115 different organizations. Thirty-five percent of the managers surveyed
on a five-point Likert scale indicated that their current estimates were "moderately
unsatisfactory" or "very unsatisfactory." The key causes
identified by the respondents included:
- frequent requests for changes by users
- overlooked tasks
- users' lack of understanding of their own requirements
- insufficient analysis when developing an estimate
- lack of coordination of systems development, technical services,
operations, data
- administration, and other functions during development
- lack of an adequate method or guidelines for estimating
Several aspects of the project were noted as key influences on the estimate:
- complexity of the proposed application system
- required integration with existing systems
- complexity of the programs in the system
- size of the system expressed as number of functions or programs
- capabilities of the project team members
- project team's experience with the application
- anticipated frequency or extent of potential changes in user requirements
- project team's experience with the programming language
- database management system
- number of project team members
- extent of programming or documentation standards
- availability of tools such as application generators
- team's experience with the hardware
===========
FIG. 12 Changes in estimation accuracy as project progresses (Boehm
et al. 1995).
There are sometimes hidden costs that are not apparent to the managers
and developers. For example, studies indicate that a programmer needs
a minimum amount of space and quiet to be able to work effectively. McCue
(1978) reported to his colleagues at IBM that the minimum standard for
programmer work space should be 100 square feet of dedicated floor space
with 30 square feet of horizontal work surface. The space also needs
a floor -to -ceiling enclosure for noise protection. DeMarco and Lister's
(1987) work suggests that programmers free from telephone calls and uninvited
visitors are more efficient and produce a better product than those who
are subject to repeated interruption.
Other project costs involve purchasing software and tools to support
development efforts. In addition to tools for designing and coding the
system, the project may buy software to capture requirements, organize
documentation, test the code, keep track of changes, generate test data,
support group meetings, and more. These tools, sometimes called Computer-Aided
Software Engineering (or CASE) tools, are some times required by the
customer or are part of a company's standard software development process.
The two types of organizational structure can be combined, where appropriate.
For instance, programmers may be asked to develop a subsystem on their
own, using an egoless approach within a hierarchical structure. Or the
test team of a loosely structured project may impose a hierarchical structure
on itself and designate one person to be responsible for all major testing
decisions.
For most projects, the biggest component of cost is effort. We must
determine how many staff-days of effort will be required to complete
the project. Effort is certainly the cost component with the greatest
degree of uncertainty. We have seen how work style, project organization,
ability, interest, experience, training, and other employee characteristics
can affect the time it takes to complete a task. Moreover, when a group
of workers must communicate and consult with one another, the effort
needed is increased by the time required for meetings, documentation,
and training.
Cost, schedule, and effort estimation must be done as early as possible
during the project's life cycle, since it affects resource allocation
and project feasibility. (If it costs too much, the customer may cancel
the project.) But estimation should be done repeatedly throughout the
life cycle; as aspects of the project change, the estimate can be refined,
based on more complete information about the project's characteristics.

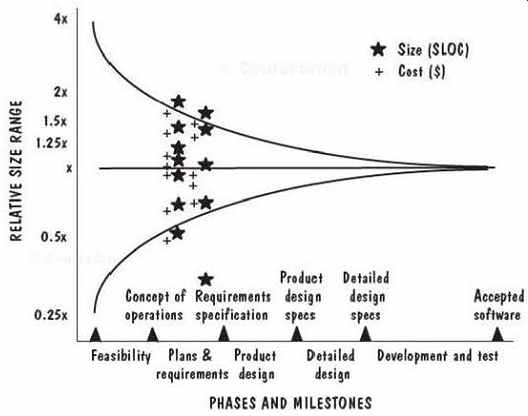

FIG. 12 illustrates how uncertainty early in the project can affect the
accuracy of cost and size estimates (Boehm et al. 1995).
The stars represent size estimates from actual projects, and the pluses
are cost estimates. The funnel-shaped lines narrowing to the right represent
Boehm's sense of how our estimates get more accurate as we learn more
about a project. Notice that when the specifics of the project are not
yet known, the estimate can differ from the eventual actual cost by a
factor of 4. As decisions are made about the product and the process,
the factor decreases. Many experts aim for estimates that are within
10 percent of the actual value, but Boehm's data indicate that such estimates
typically occur only when the project is almost done-too late to be useful
for project management.
To address the need for producing accurate estimates, software engineers
have developed techniques for capturing the relationships among effort
and staff characteristics, project requirements, and other factors that
can affect the time, effort, and cost of developing a software system.
For the rest of this section, we focus on effort-estimation techniques.
Expert Judgment
Many effort-estimation methods rely on expert judgment. Some are informal
techniques, based on a manager's experience with similar projects. Thus,
the accuracy of the prediction is based on the competence, experience,
objectivity, and perception of the estimator. In its simplest form, such
an estimate makes an educated guess about the effort needed to build
an entire system or its subsystems. The complete estimate can be computed
from either a top -down or a bottom -up analysis of what is needed.
Many times analogies are used to estimate effort. If we have already
built a system much like the one proposed, then we can use the similarity
as the basis for our estimates.
For example, if system A is similar to system B, then the cost to produce
system A should be very much like the cost to produce B. We can extend
the analogy to say that if A is about half the size or complexity of
B, then A should cost about half as much as B.
The analogy process can be formalized by asking several experts to make
three predictions: a pessimistic one (x), an optimistic one (z), and
a most likely guess (y). Then our estimate is the mean of the beta probability
distribution determined by these numbers: (x + 4y + z)/6. By using this
technique, we produce an estimate that "normalizes" the individual
estimates.
The Delphi technique makes use of expert judgment in a different way.
Experts are asked to make individual predictions secretly, based on their
expertise and using whatever process they choose. Then, the average estimate
is calculated and presented to the group. Each expert has the opportunity
to revise his or her estimate, if desired.
The process is repeated until no expert wants to revise. Some users
of the Delphi technique discuss the average before new estimates are
made; at other times, the users allow no discussion. And in another variation,
the justifications of each expert are circulated anonymously among the
experts.
Wolverton (1974) built one of the first models of software development
effort.
His software cost matrix captures his experience with project cost at
TRW, a U.S. soft ware development company. As shown in TABLE 6, the row
name represents the type of software, and the column designates its difficulty.
Difficulty depends on two factors:
whether the problem is old (O) or new (N) and whether it is easy (E),
moderate (M), or hard (H).
The matrix elements are the cost per line of code, as calibrated from
historical data at TRW. To use the matrix, you partition the proposed
software system into modules. Then, you estimate the size of each module
in terms of lines of code. Using the matrix, you calculate the cost per
module, and then sum over all the modules. For instance, suppose you
have a system with three modules: one input/output module that is old
and easy, one algorithm module that is new and hard, and one data management
module that is old and moderate. If the modules are likely to have 100,
200, and 100 lines of code, respectively, then the Wolverton model estimates
the cost to be
(100 X 17) + (200 X 35) + (100 X 31) = $11,800.
TABLE 6 Wolverton Model Cost Matrix
Since the model is based on TRW data and uses 1974 dollars, it is not
applicable to today's software development projects. But the technique
is useful and can be trans ported easily to your own development or maintenance
environment.
In general, experiential models, by relying mostly on expert judgment,
are subject to all its inaccuracies. They rely on the expert's ability
to determine which projects are similar and in what ways. However, projects
that appear to be very similar can in fact be quite different. For example,
fast runners today can run a mile in 4 minutes. A marathon race requires
a runner to run 26 miles and 365 yards. If we extrapolate the 4-minute
time, we might expect a runner to run a marathon in 1 hour and 45 minutes.
Yet a marathon has never been run in under 2 hours. Consequently, there
must be characteristics of running a marathon that are very different
from those of running a mile. Like wise, there are often characteristics
of one project that make it very different from another project, but
the characteristics are not always apparent.
Even when we know how one project differs from another, we do not always
know how the differences affect the cost. A proportional strategy is
unreliable, because project costs are not always linear: Two people cannot
produce code twice as fast as one. Extra time may be needed for communication
and coordination, or to accommodate differences in interest, ability,
and experience. Sackman, Erikson, and Grant (1968) found that the productivity
ratio between best and worst programmers averaged 10 to 1, with no easily
definable relationship between experience and performance. Likewise,
a more recent study by Hughes (1996) found great variety in the way software
is designed and developed, so a model that may work in one organization
may not apply to another.
Hughes also noted that past experience and knowledge of available resources
are major factors in determining cost.
Expert judgment suffers not only from variability and subjectivity,
but also from dependence on current data. The data on which an expert
judgment model is based must reflect current practices, so they must
be updated often. Moreover, most expert judgment techniques are simplistic,
neglecting to incorporate a large number of factors that can affect the
effort needed on a project. For this reason, practitioners and researchers
have turned to algorithmic methods to estimate effort.
Algorithmic Methods
Researchers have created models that express the relationship between
effort and the factors that influence it. The models are usually described
using equations, where effort is the dependent variable, and several
factors (such as experience, size, and application type) are the independent
variables. Most of these models acknowledge that project size is the
most influential factor in the equation by expressing effort as:
E = (a + bSc)m(X)
where S is the estimated size of the system, and a, b, and c are constants.
X is a vector of cost factors, x1 through xn, and m is an adjustment
multiplier based on these factors.
In other words, the effort is determined mostly by the size of the proposed
system, adjusted by the effects of several other project, process, product,
or resource characteristics.
===========
TABLE 7 Walston and Felix Model Productivity Factors
1. Customer interface complexity
2. User participation in requirements definition
3. Customer -originated program design changes
4. Customer experience with the application area
5. Overall personnel experience
6. Percentage of development programmers who participated in the design
of functional specifications
7. Previous experience with the operational computer
8. Previous experience with the programming language
9. Previous experience with applications of similar size and complexity
10. Ratio of average staff size to project duration (people per month)
11. Hardware under concurrent development
12. Access to development computer open under special request
13. Access to development computer closed
14. Classified security environment for computer and at least 25% of
programs and data
15. Use of structured programming
16. Use of design and code inspections
17. Use of top -down development
18. Use of a chief programmer team
19. Overall complexity of code
20. Complexity of application processing
21. Complexity of program flow
22. Overall constraints on program's design
23. Design constraints on the program's main storage
24. Design constraints on the program's timing
25. Code for real-time or interactive operation A or for execution under
severe time constraints
26. Percentage of code for delivery
27. Code classified as nonmathematical application and input/output
formatting programs
28. Number of classes of items in the database per 1000 lines of code
29. Number of pages of delivered documentation per 1000 lines of code
==========
TABLE 8 Bailey-Basili Effort Modifiers
===========
Each of the 29 factors was weighted by 1 if the factor increases productivity,
0 if it has no effect on productivity, and -1 if it decreases productivity.
A weighted sum of the 29 factors was then used to generate an effort
estimate from the basic equation.
Bailey and Bashi (1981) suggested a modeling technique, called a meta-model,
for building an estimation equation that reflects your own organization's
characteristics.
They demonstrated their technique using a database of 18 scientific
projects written in Fortran at NASA's Goddard Space Flight Center. First,
they minimized the standard error estimate and produced an equation that
was very accurate:
E=ss+n 71V-16
Then, they adjusted this initial estimate based on the ratio of errors.
If R is the ratio between the actual effort, E, and the predicted effort,
E', then the effort adjustment is defined as
JR - 1 E Rad/ - 1/R if R 1 if R < 1
They then adjusted the initial effort estimate E_adj this way:
{(1 ERadi)E E ad; =
E/(1 + ERadj) if R 1 if R < 1
Finally, Bailey and Basil (1981) accounted for other factors that affect
effort, shown in TABLE 8. For each entry in the table, the project is
scored from 0 (not present) to 5 (very important), depending on the judgment
of the project manager.
Thus, the total score for METH can be as high as 45, for CPLX as high
as 35, and for EXP as high as 25.
Their model describes a procedure, based on multi-linear least -square
regression, for using these scores to further modify the effort estimate.
Clearly, one of the problems with models of this type is their dependence
on size as a key variable.
Estimates are usually required early, well before accurate size information
is available, and certainly before the system is expressed as lines of
code. So the models simply translate the effort -estimation problem to
a size -estimation problem.
Boehm's Constructive Cost Model (COCOMO) acknowledges this problem and
incorporates three sizing techniques in the latest version, COCOMO II.
Boehm (1981) developed the original COCOMO model in the 1970s, using
an extensive database of information from projects at TRW, an American
company that built software for many different clients. Considering software
development from both an engineering and an economics viewpoint, Boehm
used size as the primary determinant of cost and then adjusted the initial
estimate using over a dozen cost drivers, including attributes of the
staff, the project, the product, and the development environment. In
the 1990s, Boehm updated the original COCOMO model, creating COCOMO II
to reflect the ways in which software development had matured.
The COCOMO II estimation process reflects three major stages of any
development project. Whereas the original COCOMO model used delivered
source lines of code as its key input, the new model acknowledges that
lines of code are impossible to know early in the development cycle.
At stage 1, projects usually build prototypes to resolve high -risk issues
involving user interfaces, software and system interaction, performance,
or technological maturity. Here, little is known about the likely size
of the final product under consideration, so COCOMO II estimates size
in what its creators call application points. As we shall see, this technique
captures size in terms of high level effort generators, such as the number
of screens and reports, and the number of third-generation language
components.
At stage 2, the early design stage, a decision has been made to move
forward with development, but the designers must explore alternative
architectures and concepts of operation. Again, there is not enough information
to support fine-grained effort and duration estimation, but far more
is known than at stage 1. For stage 2, COCOMO II employs function points
as a size measure. Function points, a technique explored in depth in
IFPUG (1994a and b), estimate the functionality captured in the requirements,
so they offer a richer system description than application points.
By stage 3, the post-architecture stage, development has begun, and
far more information is known. In this stage, sizing can be done in terms
of function points or lines of code, and many cost factors can be estimated
with some degree of comfort.
COCOMO II also includes models of reuse, takes into account maintenance
and breakage (i.e., the change in requirements over time), and more.
As with the original COCOMO, the model includes cost factors to adjust
the initial effort estimate. A research group at the University of Southern
California is assessing and improving its accuracy.
Let us look at COCOMO II in more detail. The basic model is of the form
E = b m(X)
where the initial size -based estimate, bSc, is adjusted by the vector
of cost driver information, m(X). TABLE 9 describes the cost drivers
at each stage, as well as the use of other models to modify the estimate.
TABLE 9 Three Stages of COCOMO II
At stage 1, application points supply the size measure. This size measure
is an extension of the object -point approach suggested by Kauffman and
Kumar (1993) and productivity data reported by Banker, Kauffman, and
Kumar (1992). To compute application points, you first count the number
of screens, reports, and third -generation language components that will
be involved in the application. It is assumed that these elements are
defined in a standard way as part of an integrated computer -aided soft
ware engineering environment. Next, you classify each application element
as simple, medium, or difficult. TABLE 10 contains guidelines for this
classification.
TABLE 10 Application Point Complexity Levels
of reuse, requirements change, and maintenance. The scale (i.e., the
value for c in the effort equation) had been set to 1.0 in stage 1; for
stage 2, the scale ranges from 0.91 to The number to be used for simple,
medium, or difficult application points is a complexity weight found
in TABLE 11. The weights reflect the relative effort required to implement
a report or screen of that complexity level.
Then, you sum the weighted reports and screens to obtain a single application-point
number. If r percent of the objects will be reused from previous projects,
the number of new application points is calculated to be:
New application points = (application points) x (100 - r )/100
To use this number for effort estimation, you use an adjustment factor,
called a productivity rate, based on developer experience and capability,
coupled with CASE maturity and capability. For example, if the developer
experience and capability are rated low, and the CASE maturity and capability
are rated low, then TABLE 12 tells us that the productivity factor is
7, so the number of person -months required is the number of new application
points divided by 7. When the developers' experience is low but CASE
maturity is high, the productivity estimate is the mean of the two values:
16. Likewise, when a team of developers has experience levels that vary,
the productivity estimate can use the mean of the experience and capability
weights.
TABLE 11 Complexity Weights for Application Points
TABLE 12 Productivity Estimate Calculation
At stage 1, the cost drivers are not applied to this effort estimate.
However, at stage 2, the effort estimate, based on a function -point
calculation, is adjusted for degree 1.23, depending on the degree of
novelty of the system, conformity, early architecture and risk resolution,
team cohesion, and process maturity.
The cost drivers in stages 2 and 3 are adjustment factors expressed
as effort multi pliers based on rating your project from "extra
low" to "extra high," depending on its characteristics.
For example, a development team's experience with an application type
is considered to be:
- extra low if it has fewer than 3 months of experience
- very low if it has at least 3 but fewer than 5 months of experience
- low if it has at least 5 but fewer than 9 months of experience
- nominal if it has at least 9 months but less than one year of experience
- high if it has at least 1 year but fewer than 2 years of experience
- very high if it has at least 2 years but fewer than 4 years of experience
- extra high if it has at least 4 years of experience
Similarly, analyst capability is measured on an ordinal scale based
on percentile ranges.
For instance, the rating is "very high" if the analyst is
in the ninetieth percentile and "nominal" for the fifty-fifth
percentile. Correspondingly, COCOMO II assigns an effort multiplier ranging
from 1.42 for very low to 0.71 for very high. These multipliers reflect
the notion that an analyst with very low capability expends 1.42 times
as much effort as a nominal or average analyst, while one with very high
capability needs about three quarters the effort of an average analyst.
Similarly, TABLE 13 lists the cost driver categories for tool use, and
the multipliers range from 1.17 for very low to 0.78 for very high.
========
TABLE 13 Tool Use Categories
Category Meaning
Very low Edit, code, debug
Low Simple front-end, back -end CASE, little integration Nominal Basic
life -cycle tools, moderately integrated High Strong, mature life -cycle
tools, moderately integrated Very high Strong, mature, proactive life
-cycle tools, well -integrated with processes, methods, reuse
=========
Notice that stage 2 of COCOMO II is intended for use during the early
stages of design. The set of cost drivers in this stage is smaller than
the set used in stage 3, reflecting lesser understanding of the project's
parameters at stage 2.
The various components of the COCOMO model are intended to be tailored
to fit the characteristics of your own organization. Tools are available
that implement COCOMO II and compute the estimates from the project characteristics
that you sup ply. Later in this section, we will apply COCOMO to our
information system example.
Machine-Learning Methods
In the past, most effort- and cost-modeling techniques have relied on
algorithmic methods. That is, researchers have examined data from past
projects and generated equations from them that are used to predict effort
and cost on future projects. How ever, some researchers are looking to
machine learning for assistance in producing good estimates. For example,
neural networks can represent a number of interconnected, interdependent
units, so they are a promising tool for representing the various activities
involved in producing a software product. In a neural network, each unit
(called a neuron and represented by network node) represents an activity;
each activity has inputs and outputs. Each unit of the network has associated
software that performs an accounting of its inputs, computing a weighted
sum; if the sum exceeds a threshold value, the unit produces an output.
The output, in turn, becomes input to other related units in the net
work, until a final output value is produced by the network. The neural
network is, in a sense, an extension or the activity graphs we examined
earlier in this section.
There are many ways for a neural network to produce its outputs. Some
techniques involve looking back to what has happened at other nodes;
these are called back-propagation techniques. They are similar to the
method we used with activity graphs to look back and determine the slack
on a path. Other techniques look forward, to anticipate what is about
to happen.
Neural networks are developed by "training" them with data
from past projects.
Relevant data are supplied to the network, and the network uses forward
and back ward algorithms to "learn" by identifying patterns
in the data. For example, historical data about past projects might contain
information about developer experience; the network may identify relationships
between level of experience and the amount of effort required to complete
a project.
FIG. 13 illustrates how Shepperd (1997) used a neural network to produce

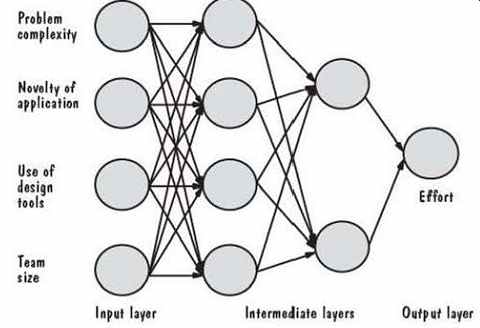

an effort estimate. There are three layers in the network, and the network
has no cycles.
The four inputs are factors that can affect effort on a project; the
network uses them to produce effort as the single output. To begin, the
network is initialized with random weights. Then, new weights, calculated
as a "training set" of inputs and outputs based on past history,
are fed to the network. The user of the model specifies a training algorithm
that explains how the training data are to be used; this algorithm is
also based on past history, and it commonly involves back -propagation.
Once the network is trained (i.e., once the network values are adjusted
to reflect past experience), it can then be used to estimate effort on
new projects.
FIG. 13 Shepperd's feed -forward neural network.
Several researchers have used back -propagation algorithms on similar
neural networks to predict development effort, including estimation for
projects using fourth -generation languages (Wittig and Finnie 1994;
Srinivasan and Fisher 1995; Samson, Ellison, and Dugard 1997). Shepperd
(1997) reports that the accuracy of this type of model seems to be sensitive
to decisions about the topology of the neural network, the number of
learning stages, and the initial random weights of the neurons within
the network. The networks also seem to require large training sets in
order to give good predictions. In other words, they must be based on
a great deal of experience rather than a few representative projects.
Data of this type are sometimes difficult to obtain, especially collected
consistently and in large quantity, so the paucity of data limits this
technique's usefulness. Moreover, users tend to have difficulty understanding
neural networks. However, if the technique produces more accurate estimates,
organizations may be more willing to collect data for the networks.
In general, this "learning" approach has been tried in different
ways by other researchers. Srinivasan and Fisher (1995) used Kemerer's
data (Kemerer 1989) with a statistical technique called a regression
tree; they produced predictions more accurate than those of the original
COCOMO model and SLIM, a proprietary commercial model. However, their
results were not as good as those produced by a neural network or a model
based on function points. Briand, Basili, and Thomas (1992) obtained
better results from using a tree induction technique, using the Kemerer
and COCOMO datasets. Porter and Selby (1990) also used a tree-based approach;
they constructed a decision tree that identifies which project, process,
and product characteristics may be useful in predicting likely effort.
They also used the technique to predict which modules are likely to be
fault-prone.
A machine -learning technique called Case -Based Reasoning (CBR) can
be applied to analogy -based estimates. Used by the artificial intelligence
community, CBR builds a decision algorithm based on the several combinations
of inputs that might be encountered on a project. Like the other techniques
described here, CBR requires information about past projects. Shepperd
(1997) points out that CBR offers two clear advantages over many of the
other techniques. First, CBR deals only with events that actually occur,
rather than with the much larger set of all possible occurrences. This
same feature also allows CBR to deal with poorly understood domains.
Second, it is easier for users to understand particular cases than to
depict events as chains of rules or as neural networks.
Estimation using CBR involves four steps:
1. The user identifies a new problem as a case.
2. The system retrieves similar cases from a repository of historical
information.
3. The system reuses knowledge from previous cases.
4. The system suggests a solution for the new case.
The solution may be revised, depending on actual events, and the outcome
is placed in the repository, building up the collection of completed
cases. However, there are two big hurdles in creating a successful CBR
system: characterizing cases and determining similarity.
Cases are characterized based on the information that happens to be
available.
Usually, experts are asked to supply a list of features that are significant
in describing cases and, in particular, in determining when two cases
are similar. In practice, similarity is usually measured using an n -dimensional
vector of n features. Shepperd, Schofield, and Kitchenham (1996) found
a CBR approach to be more accurate than traditional regression analysis
-based algorithmic methods.
Finding the Model for Your Situation
There are many effort and cost models being used today: commercial tools
based on past experience or intricate models of development, and home-grown
tools that access databases of historical information about past projects.
Validating these models (i.e., making sure the models reflect actual
practice) is difficult, because a large amount of data is needed for
the validation exercise. Moreover, if a model is to apply to a large
and varied set of situations, the supporting database must include measures
from a very large and varied set of development environments.
Even when you find models that are designed for your development environment,
you must be able to evaluate which are the most accurate on your projects.
There are two statistics that are often used to help you in assessing
the accuracy, PRED and MMRE. PRED(x/100) is the percentage of projects
for which the estimate is within x% of the actual value. For most effort,
cost, and schedule models, managers evaluate PRED(0.25), that is, those
models whose estimates are within 25% of the actual value; a model is
considered to function well if PRED(0.25) is greater than 75%. MMRE is
the mean magnitude of relative error, so we hope that the MMRE for a
particular model is very small. Some researchers consider an MMRE of
0.25 to be fairly good, and Boehm (1981) suggests that MMRE should be
0.10 or less. TABLE 14 lists the best values for PRED and MMRE reported
in the literature for a variety of models. As you can see, the statistics
for most models are disappointing, indicating that no model appears to
have captured the essential characteristics and their relationships for
all types of development. However, the relationships among cost factors
are not simple, and the models must be flexible enough to handle changing
use of tools and methods.
TABLE 14 Summary of Model Performance
Moreover, Kitchenham, MacDonell, Pickard, and Shepperd (2000) point
out that the MMRE and PRED statistics are not direct measures of estimation
accuracy. They suggest that you use the simple ratio of estimate to actual:
estimate/actual. This mea sure has a distribution that directly reflects
estimation accuracy. By contrast, MMRE and PRED are measures of the spread
(standard deviation) and peakedness (kurtosis) of the ratio, so they
tell us only characteristics of the distribution.
Even when estimation models produce reasonably accurate estimates, we
must be able to understand which types of effort are needed during development.
For example, designers may not be needed until the requirements analysts
have finished developing the specification. Some effort and cost models
use formulas based on past experience to apportion the effort across
the software development life cycle. For instance, the original COCOMO
model suggested effort required by development activity, based on percentages
allotted to key process activities. But, as FIG. 14 illustrates, researchers

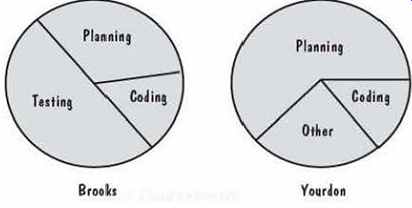

report conflicting values for these percentages (Brooks 1995; Yourdon
1982). Thus, when you are building your own database to support estimation
in your organization, it is important to record not only how much effort
is expended on a project, but also who is doing it and for what activity.
FIG. 14 Different reports of effort distribution.
==========
SIDEBAR 4 BOEHM'S TOP TEN RISK ITEMS
Boehm (19911 identities 10 risk items and recommends risk management
techniques to 15 address them.
1. Personnel shortfalls. Staffing with top talent; job matching; team
building; morale building; cross -training; pre-scheduling key people.
2. Unrealistic schedules and budgets. Detailed multisource cost and
schedule estimation; design to cost; incremental development; software
reuse; requirements scrubbing.
3. Developing the wrong software functions. Organizational analysis;
mission analysis; operational concept formulation; user surveys; prototyping;
early user's manuals.
4. Developing the wrong user interface. Prototyping; scenarios; task
analysis.
5. Gold plating. Requirements scrubbing; prototyping; cost -benefit
analysis; design to cost.
6. Continuing stream of requirements changes. High change threshold;
information hiding; incremental development (defer changes to later increments).
7. Shortfalls in externally performed tasks. Reference checking; pre-award
audits; award -fee contracts; competitive design or prototyping; team
building.
8. Shortfalls in externally furnished components. Benchmarking; inspections;
reference checking; compatibility analysis.
9. Real-time performance shortfalls. Simulation; benchmarking; modeling;
prototyping; instrumentation; tuning.
10. Straining computer science capabilities Technical analysis; cost
-benefit analysis; prototyping; reference checking.
===========
4. RISK MANAGEMENT
As we have seen, many software project managers take steps to ensure
that their projects are done on time and within effort and cost constraints.
However, project management involves far more than tracking effort and
schedule. Managers must determine whether any unwelcome events may occur
during development or maintenance and make plans to avoid these events
or, if they are inevitable, minimize their negative consequences. A risk
is an unwanted event that has negative consequences. Project managers
must engage in risk management to understand and control the risks on
their projects.
What Is a Risk?
Many events occur during software development; SIDEBAR 4 lists Boehm's
view of some of the riskiest one& We distinguish risks from other
project events by looking for three things (Rook 1993):
1. A loss associated with the event. The event must create a situation
where some thing negative happens to the project: a loss of time, quality,
money, control, understanding, and so on. For example, if requirements
change dramatically after the design is done, then the project can suffer
from loss of control and under standing if the new requirements are for
functions or features with which the design team is unfamiliar. And a
radical change in requirements is likely to lead to losses of time and
money if the design is not flexible enough to be changed quickly and
easily. The loss associated with a risk is called the risk impact.
2. The likelihood that the event will occur. We must have some idea
of the probability that the event will occur. For example, suppose a
project is being developed on one machine and will be ported to another
when the system is fully tested. If the second machine is a new model
to be delivered by the vendor, we must estimate the likelihood that it
will not be ready on time. The likelihood of the risk, measured from
0 (impossible) to 1 (certainty) is called the risk probability. When
the risk probability is 1, then the risk is called a problem, since it
is certain to happen.
3. The degree to which we can change the outcome. For each risk, we
must determine what we can do to minimize or avoid the impact of the
event. Risk control involves a set of actions taken to reduce or eliminate
a risk. For example, if the requirements may change after design, we
can minimize the impact of the change by creating a flexible design.
If the second machine is not ready when the software is tested, we may
be able to identify other models or brands that have the same functionality
and performance and can run our new software until the new model is delivered.
We can quantify the effects of the risks we identify by multiplying
the risk impact by the risk probability, to yield the risk exposure.
For example, if the likelihood that the requirements will change after
design is 0.3, and the cost to redesign to new requirements is $50,000,
then the risk exposure is $15,000. Clearly, the risk probability can
change over time, as can the impact, so part of a project manager's job
is to track these values over time and plan for the events accordingly.
There are two major sources of risk: generic risks and project -specific
risks.
Generic risks are those common to all software projects, such as misunderstanding
the requirements, losing key personnel, or allowing insufficient time
for testing. Project-specific risks are threats that result from the
particular vulnerabilities of the given project. For example, a vendor
may be promising network software by a particular date, but there is
some risk that the network software will not be ready on time.
Risk Management Activities
Risk management involves several important steps, each of which is illustrated
in FIG. 15. First, we assess the risks on a project, so that we understand
what may occur during the course of development or maintenance. The assessment
consists of three activities: identifying the risks, analyzing them,
and assigning priorities to each of them. To identify them, we may use
many different techniques.

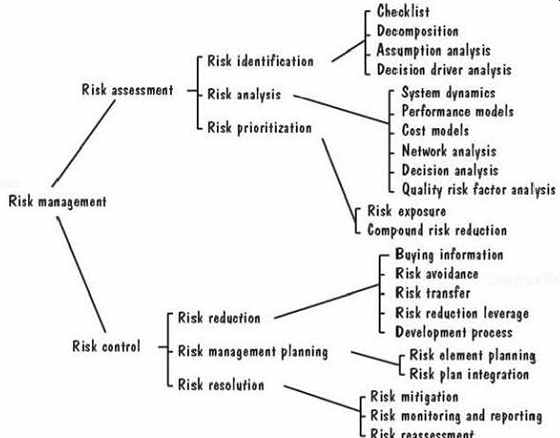

FIG. 15 Steps in risk management (Rook 1993).
If the system we are building is similar in some way to a system we
have built before, we may have a checklist of problems that may occur;
we can review the check list to determine if the new project is likely
to be subject to the risks listed. For systems that are new in some way,
we may augment the checklist with an analysis of each of the activities
in the development cycle; by decomposing the process into small pieces,
we may be able to anticipate problems that may arise. For example, we
may decide that there is a risk of the chief designer leaving during
the design process. Similarly, we may analyze the assumptions or decisions
we make about how the project will be done, who will do it, and with
what resources. Then, each assumption is assessed to determine the risks
involved.
Finally, we analyze the risks we have identified, so that we can understand
as much as possible about when, why, and where they might occur. There
are many techniques we can use to enhance our understanding, including
system dynamics models, cost models, performance models, network analysis,
and more.
Once we have itemized all the risks, we use our understanding to assign
priorities them. A priority scheme enables us to devote our limited resources
only to the most threatening risks. Usually, priorities are based on
the risk exposure, which takes into account not only likely impact, but
also the probability of occurrence.
The risk exposure is computed from the risk impact and the risk probability,
so we must estimate each of these risk aspects. To see how the quantification
is done, consider the analysis depicted in FIG. 16. Suppose we have analyzed
the system development process and we know we are working under tight
deadlines for delivery. We have decided to build the system in a series
of releases, where each release has more functionality than the one that
preceded it. Because the system is designed so that functions are relatively
independent, we consider testing only the new functions for a release,
and we assume that the existing functions still work as they did before.
However, we may worry that there are risks associated with not performing
regression testing the assurance that existing functionality still works
correctly.

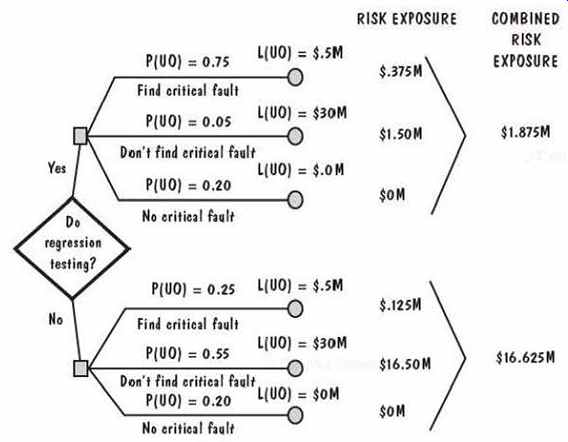

FIG. 16 Example of risk exposure calculation.
For each possible outcome, we estimate two quantities: the probability
of an unwanted outcome, P(UO), and the loss associated with the unwanted
outcome, P(UO), and the loss associated with the unwanted outcome, L(UO).
For instance, there are three possible consequences of performing regression
testing: finding a critical fault if one exists, not finding the critical
fault (even though it exists), or deciding (correctly) that there is
no critical fault. As the figure illustrates, we have estimated the probability
of the first case to be 0.75, of the second to be 0.05, and of the third
to be 0.20. The loss associated with an unwanted outcome is estimated
to be $500,000 if a critical fault is found, so that the risk exposure
is $375,000. Similarly, we calculate the risk exposure for the other
branches of this decision tree, and we find that our risk exposure if
we perform regression testing is almost $2 million. However, the same
kind of analysis shows us that the risk exposure if we do not perform
regression testing is almost $17 million. Thus, we say (loosely) that
more is at risk if we do not perform regression testing.
Risk exposure helps us to list the risks in priority order, with the
risks of most concern given the highest priority. Next, we must take
steps to control the risks. The notion of control acknowledges that we
may not be able to eliminate all risk& Instead, we may be able to
minimize the risk or mitigate it by taking action to handle the unwanted
out come in an acceptable way. Therefore, risk control involves risk
reduction, risk planning, and risk resolution.
There are three strategies for risk reduction:
- avoiding the risk, by changing requirements for performance or functionality
- transferring the risk, by allocating risks to other systems or by
buying insurance to cover any financial loss should the risk become
a reality
- assuming the risk, by accepting it and controlling it with the project's
resources
To aid decision making about risk reduction, we must take into account
the cost of reducing the risk. We call risk leverage the difference in
risk exposure divided by the cost of reducing the risk. In other words,
risk reduction leverage is:
(Risk exposure before reduction - risk exposure after reduction) / (cost
of risk reduction)
If the leverage value is not high enough to justify the action, then
we can look for other less costly or more effective reduction techniques.
In some cases, we can choose a development process to help reduce the
risk. For example, we saw in Section 2 that prototyping can improve understanding
of the requirements and design, so selecting a prototyping process can
reduce many project risks.
It is useful to record decisions in a risk management plan, so that
both customer and development team can review how problems are to be
avoided, as well as how they are to be handled should they arise. Then,
we should monitor the project as development progresses, periodically
reevaluating the risks, their probability, and their likely impact.
5. THE PROJECT PLAN
To communicate risk analysis and management, project cost estimates,
schedule, and organization to our customers, we usually write a document
called a project plan. The plan puts in writing the customer's needs,
as well as what we hope to do to meet them.
The customer can refer to the plan for information about activities
in the development process, making it easy to follow the project's progress
during development. We can also use the plan to confirm with the customer
any assumptions we are making, especially about cost and schedule.
A good project plan includes the following items:
1. project scope
2. project schedule
3. project team organization
4. technical description of the proposed system
5. project standards, procedures, and proposed techniques and tools
6. quality assurance plan
7. configuration management plan
8. documentation plan
9. data management plan
10. resource management plan
11. test plan
12. training plan
13. security plan
14. risk management plan
15. maintenance plan
The scope defines the system boundary, explaining what will be included
in the system and what will not be included. It assures the customer
that we understand what is wanted. The schedule can be expressed using
a work breakdown structure, the deliverables, and a timeline to show
what will be happening at each point during the project life cycle. A
Gantt chart can be useful in illustrating the parallel nature of some
of the development tasks.
The project plan also lists the people on the development team, how
they are organized, and what they will be doing. As we have seen, not
everyone is needed all the time during the project, so the plan usually
contains a resource allocation chart to show staffing, levels at different
times.
Writing a technical description forces us to answer questions and address
issues as we anticipate how development will proceed. This description
lists hardware and software, including compilers, interfaces, and special-purpose
equipment or software.
Any special restrictions on cabling, execution time, response time,
security, or other aspects of functionality or performance are documented
in the plan. The plan also lists any standards or methods that must be
used, such as:
- algorithms
- tools
- review or inspection techniques
- design languages or representations
- coding languages
- testing techniques
For large projects, it may be appropriate to include a separate quality
assurance plan, to describe how reviews, inspections, testing, and other
techniques will help to evaluate quality and ensure that it meets the
customer's needs. Similarly, large projects need a configuration management
plan, especially when there are to be multiple versions and releases
of the system. As we will see in Section 10, configuration management
helps to control multiple copies of the software. The configuration management
plan tells the customer how we will track changes to the requirements,
design, code, test plans, and documents.
Many documents are produced during development, especially for large
projects where information about the design must be made available to
project team members.
the project plan lists the documents that will be produced, explains
who will write them and when, and, in concert with the configuration
management plan, describes how documents will be changed.
Because every software system involves data for input, calculation,
and output, the project plan must explain how data will be gathered,
stored, manipulated, and archived. The plan should also explain how resources
will be used. For example, if the hardware configuration includes removable
disks, then the resource management part of the project plan should explain
what data are on each disk and how the disk packs or diskettes will be
allocated and backed up.
Testing requires a great deal of planning to be effective, and the project
plan describes the project's overall approach to testing. In particular,
the plan should state how test data will be generated, how each program
module will be tested (e.g., by testing all paths or all statements),
how program modules will be integrated with each other and tested, how
the entire system will be tested, and who will perform each type of testing.
Sometimes, systems are produced in stages or phases, and the test plan
should explain how each stage will be tested. When new functionality
is added to a sys tem in stages, as we saw in Section 2, then the test
plan must address regression testing, ensuring that the existing functionality
still works correctly.
Training classes and documents are usually prepared during development,
rather than after the system is complete, so that training can begin
as soon as the system is ready ( and sometimes before). The project plan
explains how training will occur, describing each class, supporting software
and documents, and the expertise needed by each student.
When a system has security requirements, a separate security plan is
sometimes needed. The security plan addresses the way that the system
will protect data, users, and hardware. Since security involves confidentiality,
availability, and integrity, the plan must explain how each facet of
security affects system development. For example, if access to the system
will be limited by using passwords, then the plan must describe who issues
and maintains the passwords, who develops the password -handling soft
ware, and what the password encryption scheme will be.
Finally, if the project team will maintain the system after it is delivered
to the user, the project plan should discuss responsibilities for changing
the code, repairing the hardware, and updating supporting documentation
and training materials.
PREV. | NEXT
top of page Home |
