Quick Tour of Project Management: Integration of Organization Strategy with Projects

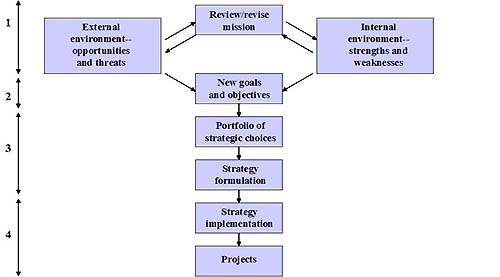

Strategic Management Process

Strategic Management Process Includes Four Activities:

1. Review and define the organizational mission.
2. Set long-range goals and objectives.
3. Analyze and formulate strategies to reach objectives.
4. Implement strategies through projects.

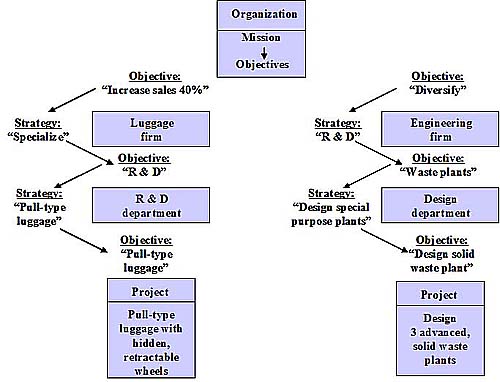

Strategy, Objectives and Project Linkages

Organization: Mission --> Objectives

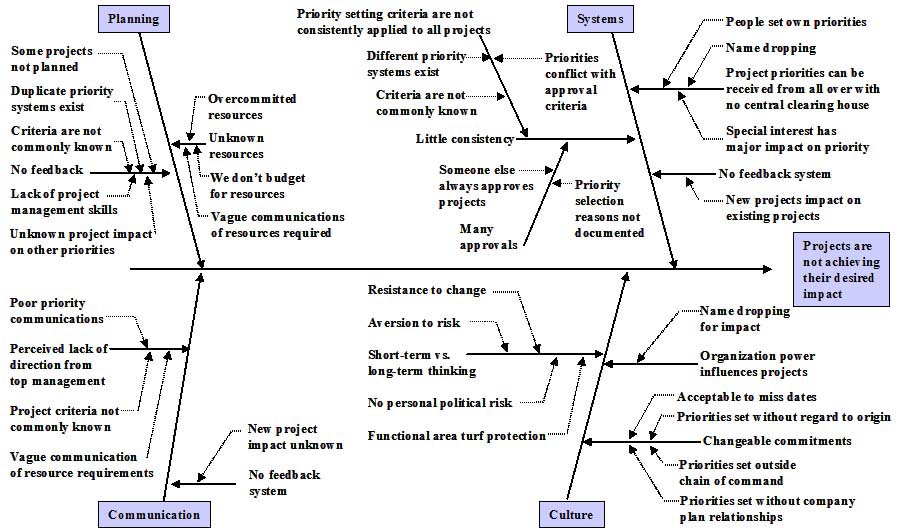

Cause-and-Effect Worksheet Example

Click here for larger image: Cause-and-Effect Worksheet Example
Click here for larger version of above diagram

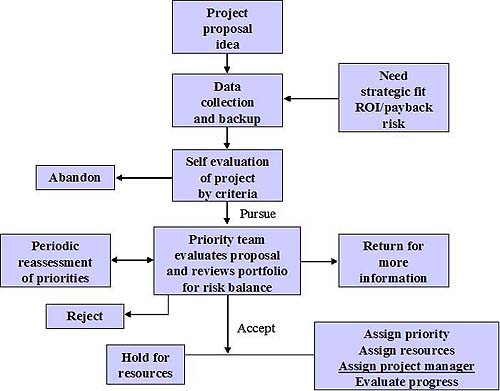

Project Screening Process

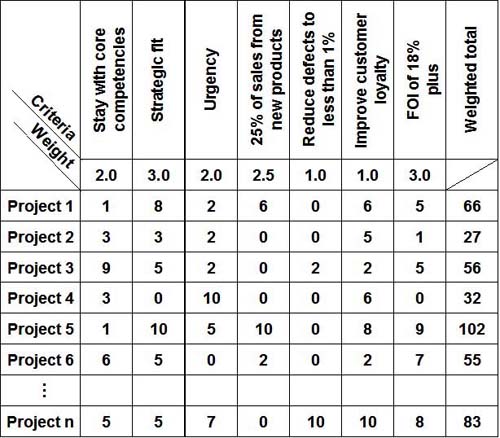

Project Screening Matrix

Project proposal idea

|
|
|
V

Data collection and backup <-- Need strategic fit ROI/payback risk

|
|
|
V

Abandon <-- Self evaluation of project by criteria

|
| (Pursue)
|
V

Periodic reassessment of priorities <--> Priority team evaluates proposal and reviews portfolio for risk balance --> Return for more information

<-- Reject
|
| (Accept)
|
V

Hold for resources ---- Assign priority, Assign resources, Assign project manager, Evaluate progress

Project Screening Matrix

For any given project(s)/project proposal(s) within an organization (i.e. Project 1 through Project n), this matrix assigns weight to the following project criteria:

  • Stay with core competencies


  • Strategic fit


  • Urgency


  • 25% of sales from new products


  • Reduce defects to less than 1%


  • Improve customer loyalty


  • FOI of 18% plus


  • Weighted total

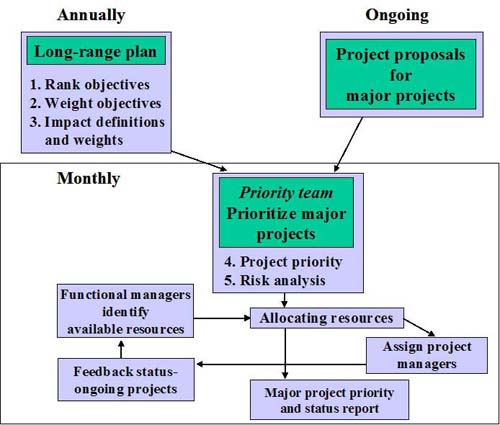

Project Priority System

Annually (Long-range plan) / Ongoing (Project proposals for major projects)

… both lead to…

Monthly

Priority team: Prioritize major projects (includes Project priority and Risk analysis) --> Allocating resources --> Major project priority and status report

Functional managers identify available resources --> Allocating resources --> Assign project managers --> Feedback status--ongoing projects

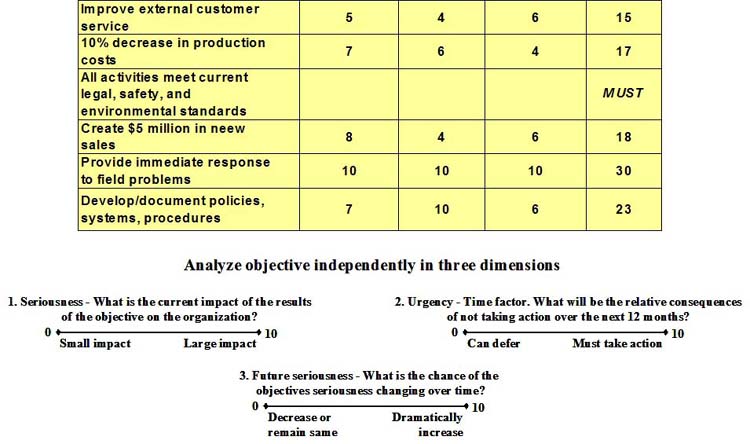

Rank Objectives

Analyze objective independently in three dimensions

1. Seriousness -- What is the current impact of the results of the objective on the organization?

(0) Small impact <-----------> (10) Large Impact

2. Urgency -- Time factor. What will be the relative consequences of not taking action over the next 12 months?

(0) Can defer <-----------> (10) Must take action

3. Future seriousness -- What is the chance of the objectives seriousness changing over time?

(0) Decrease or remain same <-----------> (10) Dramatically increase

click image for larger version
Click here for larger version of above figure

Priority Analysis

Includes:

  • Project number


  • Must objectives (e.g.: All activities meet current legal, safety, and environmental standards; All new products will have a complete market analysis)


  • Must meet if impacts


  • Total weighted score


  • Priority

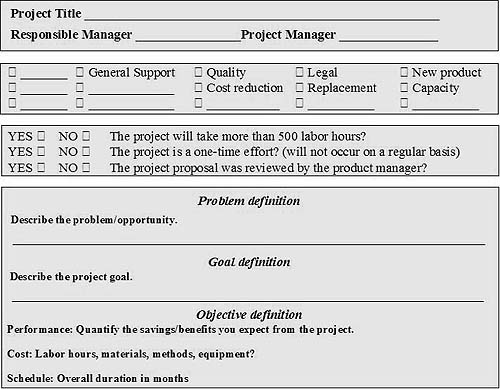

Major Project Proposal

Includes:

  • Date


  • Project Number


  • Project Title


  • Responsible Manager (name/signature)


  • Project Manager (name/signature)


  • Project type/categorization: General Support, Quality, Cost reduction, Legal, new Product, Capacity


  • Effort used (man-hours)


  • Problem definition: Describe the problem/opportunity


  • Goal definition: Describe the project goal


  • Objective definition: Performance: Quantify the savings/benefits you expect from the project; Cost: Labor hours, materials, methods, equipment?; Schedule: Overall duration in months


Above: Sample proposal document

Risk Analysis

Addresses question: What are the three major risks for this project?

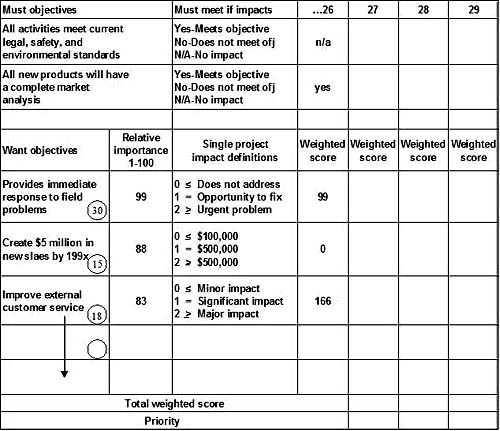

Risk Analysis report includes criteria similar to Priority Analysis:

  • Project number


  • Must objectives (e.g.: All activities meet current legal, safety, and environmental standards; All new products will have a complete market analysis)


  • Must meet if impacts


  • Want objectives (Provides immediate response to field problems; "Create $5 million in new sales by 199x"; Improve external customer service)


  • Total weighted score


  • Priority


Above: Sample Risk Analysis report
