The variety of models available to practitioners is unlimited. Picking
a selection model depends on the nature of the organization. For example,
factors such as industry, organization size, risk aversion level, technology,
competition, markets, and management style may strongly influence the form
of the model used to select projects.
In the past, financial criteria were used almost to the exclusion of other
criteria. However, in the last two decades we have witnessed a dramatic
shift to include multiple criteria in project selection. Succinctly, profitability
alone is simply not an adequate measure of contribution; however, it is
still an important criterion. A detailed discussion is beyond the scope
of this text; however, two financial models are briefly mentioned here
to give the reader a sense of the nature and potential problems of financial
models.
1. The payback model measures the time it will take to recover the project
investment. Shorter paybacks are more desirable. Payback is the simplest
and most widely used model. Payback emphasizes cash flows, a key factor
in business. Some managers use the payback model to eliminate unusually
risky projects (those with lengthy payback periods). The major limitations
of payback are that it ignores the time value of money, assumes constant
cash flows for the investment period (and not beyond), and does not consider
profitability.
2. The net present value (NPV) model uses management's minimum desired
rate of return discount rate (for example, 20 percent) to compute the present
value of all cash inflows and outflows. If the result is positive, and
the project meets the minimum desired rate of return, it is eligible for
further consideration. Higher positive NPV's are desirable. Table
1 (below) presents
simple examples of the payback and NPV models.
From Table 1 the payback method suggests project B because it has a payback
of 3.3 years. However, the NPV model rejects both projects, which have negative
present values of -$346,130 and -$61,620, because it considers the time
value of money. The NPV model is more realistic because it considers the
time value of money, cash flows, and profitability. This example demonstrates
the major shortcoming of the payback model and why model selection is important.
Models such as payback and NPV represent one criterion useful in screening
alternative projects. However, financial criteria alone obviously cannot
serve as a project screening process that establishes a clear link between
strategy and project selection.
Table 1: FINANCIAL PROJECT SELECTION CRITERIA
Given data for two potential
projects:
Project A
Project B
Cost of project
$720,000
$600,000
Estimated annual cash inflow
$125,000
$180,000
Estimated useful life of project
5 years
5 years
Required rate of return
20%
20%
Payback Period
Payback Period = Investment/Annual net
savings
= 5.8 years
= 3.3 years
Rate of return (a)
17.4%
30.0%
NPV (Net Present Value)
Present value of annual net cash inflows
Project A $125,000 x 2.991 (b)
Project B $180,000 x 2.991
Investment
NPV
$383,870
(- 720,000)
(-$346,130)
$538,380
(- $600,000)
(-$ 61,620)
Outcomes:
Payback
Project A -- 5.8 years; reject, longer than life of project (5 years)
Project B -- 3.3 years; accept, less than 5 years and exceeds 20%
desired rate of return
Net present value
Reject both projects because they have negative net present values:
a. The reciprocal of payback yields the average rate of return (e.g.,
125/720 x 100 = 17.4%).
b. Present value of an annuity of $1 for 5 years at 20 percent.
These values can be found in annuity tables of standard accounting
and finance texts.
Other factors such as researching a new technology, public image, ethical position,
protection of the environment, core competencies, and strategic fit might be
important criteria for selecting and prioritizing projects. The trend toward
using multiple screening criteria models is quickly gaining acceptance-especially
in project-driven organizations. One impetus supporting this trend was the advent
of Y2K projects (the millennium date bug).
Selection Process
Under rare circumstances, there are projects which "must" be
selected. "Must" projects are those which must be implemented
or the firm will fail or will suffer dire consequences. For example, a
manufacturing plant must install an electrostatic filter on top of a smoke
stack in six months or close down. Other examples could be a large software
firm must open its software architecture to allow other competing software
to be compatible and to interact with Y2K projects. Any project placed
in the "must" category ignores other selection criteria. A rule
of thumb for placing a proposed project in this category is that 99 percent
of the organization stakeholders should agree that the project must be
implemented; there is no perceived choice but to implement the project.
All other projects are selected using criteria linked to organization strategy.
A project selection process which uses multiple screening criteria is discussed
next.
Project Proposals
Suggestions for projects come from many internal and external sources.
It is a rare organization that does not have more project proposals than
are feasible. This is especially true in project-driven organizations.
Culling through so many proposals to identify those that add the most value

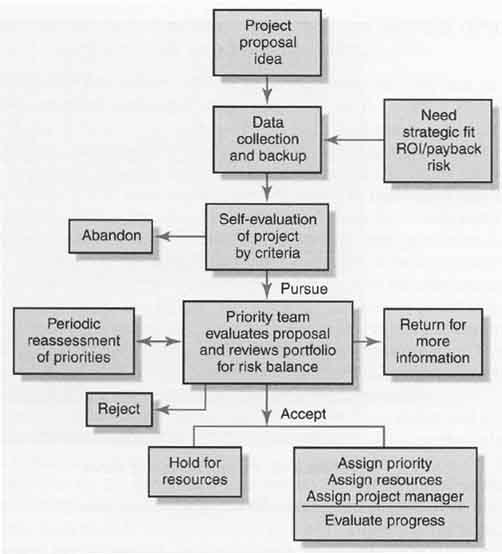

requires a structured process. Fig. 1 shows a flow chart of a screening
process, beginning with the creation of an idea for a project. Data and
information are collected to assess the value of the proposed project to
the organization and for future backup. If the sponsor decides to pursue
the project on the basis of the collected data, it is forwarded to the
project priority team (or sometimes a project office). Given the selection
criteria and current portfolio of projects, the priority team rejects or
accepts the project. If accepted, the priority team sets implementation
of the project in motion.
Priority Team Role
The role of the priority team includes more than accepting or rejecting
project proposals on the basis of selected criteria. The priority team
is responsible for publishing the priority of every project and ensuring
that the process is open and free of power politics. For example, most
organizations using a priority team or project office use an electronic
bulletin board to disperse the current portfolio of projects, the current
status of each project, and current issues. This open communication discourages
power plays. In addition, the priority team is responsible for balancing
the portfolio of projects for the organization. Hence, a proposed project
that satisfies most criteria may not be selected because the organization
portfolio already includes too many projects with the same characteristics-for
example, project risk level, use of key resources, high cost, non-revenue
producing, long durations. Such projects may be put on hold. Over time
the priority team evaluates the progress of the projects in the portfolio.
The priority team is also responsible for reassessing organizational goals
and priorities and changing priorities if conditions dictate. How well
this whole process is managed can have a profound impact on the success
of an organization.
Fig. 1: Project Screening Process
Selection Criteria
Selection criteria need to mirror the critical success factors of an organization.
For example, 3M set a target that 25 percent of the company's sales would
come from products fewer than four years old versus the old target of 20
per cent. Their priority system for project selection strongly reflects
this new target. On the other hand, failure to pick the right factors will
render the screening process "use less" in short order. Fig.

2 represents a hypothetical project scoring matrix. The screening
criteria selected are shown across the top of the matrix (stay within core
competencies ... ROI of 18 percent plus). Management weights each criterion
(a value of 0 to a high of, say, 3) by its relative importance to the organization's
objec tives and strategic plan. Project proposals are then submitted to
a project priority team or project office.
Fig. 2: Project Screening Matrix
Each project proposal is then evaluated by its relative contribution/value
added to the selected criteria. Values of 0 to a high of 10 are assigned
to each criterion for each project. This value represents the project's
fit to the specific criterion. For ex ample, project 1 appears to fit
well with the strategy of the organization since it is given a value of
8. Conversely, project 1 does nothing to support reducing defects (its
value is 0). Finally, this model applies the management weights to each
criterion by importance using a value of 1 to 3. For example, ROI and strategic
fit have a weight of 3, while urgency and core competencies have weights
of 2. Applying the weight to each criterion, the priority team derives
the weighted total points for each project. For example, project 5 has
the highest value of 102 [(2 x 1) + (3 x 10) + (2 x 5) + (2.5 x 10) + (1
x 0) + (1 x 8) + (3 x 9) = 102] and project 2 a low value of 27. If the
resources available create a cutoff threshold of 50 points, the priority
team would eliminate projects 2 and 4. (Note: Project 4 appears to have
some urgency, but it is not classified as a “must” project. Therefore,
it is screened with all other proposals.) Project 5 would receive first
priority, project n second, and so on. In rare cases where resources are
severely limited and project proposals are similar in weighted rank, it
is prudent to pick the project placing less demand on resources. Weighted
multiple criteria models similar to this one are rapidly becoming the dominant
choice for prioritizing projects.
In summary, centralized project priority systems support a holistic approach
to linking organizational projects to organizational strategy. The system
is proactive rather than reactive. The project portfolio represents a process
for controlling the use of scarce resources and balancing risk. Regardless
of the criteria used for selection, each project should be evaluated by
the same criteria. The project priority system ties re source requirements
directly to resource availability. Enforcing the project priority system
is critical. Keeping the whole system open and aboveboard is important
to maintaining the integrity of the system. For example, communicating
which projects are approved, project ranks, current status of in-process
projects, and any changes in priority criteria will keep people from bypassing
the system. Project-driven organizations are integrating organizational
goals and strategy with projects using a portfolio of projects selected
by a proactive project priority system.
